Material Planning (MRP)

Stop guessing what to buy — let FilaOps calculate material requirements from your open orders and current inventory.

What You'll Learn

  • How FilaOps MRP works and what demand sources it considers
  • How to read the Buy List and Low Stock views
  • How to turn MRP suggestions into purchase orders
  • How planned orders work (their lifecycle and how to act on them)
  • Where MRP results surface across the app

Prerequisites

What Is MRP?

MRP (Material Requirements Planning) answers three questions:

  1. What do I need? — Which materials and components are required to fill your open orders
  2. How much? — The exact quantities, accounting for what is already in stock and what is already on order
  3. When? — Timing based on lead times and order due dates

Without MRP, you are either over-ordering (tying up cash in excess inventory) or under-ordering (stopping production because you ran out of a critical material). MRP finds the balance.

How FilaOps MRP Works

graph TD
    A[Sales Orders] --> D[MRP Engine]
    B[Production Orders] --> D
    C[Current Inventory] --> D
    E[Open Purchase Orders] --> D
    F[Bills of Materials] --> D
    D --> G[Net Shortage List]
    D --> H[Planned Orders]
    G --> I[Buy List]
    H --> J[Purchase Order / Work Order]

When you run MRP, FilaOps:

  1. Collects open demand — Gathers all open sales orders and open production orders within your planning horizon
  2. Explodes BOMs — Recursively walks through each product's Bill of Materials (and routing operation materials where applicable) to calculate the total raw material required
  3. Checks current stock — Reads on-hand inventory across all locations
  4. Checks incoming supply — Subtracts quantities already on open purchase orders (draft, ordered, or partially received)
  5. Calculates net requirements — Applies the standard MRP netting formula:

    Net Shortage = Gross Demand − On Hand − Incoming Supply + Safety Stock

  6. Generates planned orders — Creates suggested purchase orders (for bought materials) and production orders (for manufactured sub-assemblies) to fill those gaps

Sales orders and production orders

FilaOps includes both open sales orders and open production orders as demand sources. Sales orders that already have linked production orders are excluded from direct sales-order processing to avoid double-counting — their demand is captured through the production order instead.

Routing materials take precedence

If a product has materials defined on routing operations, MRP uses those routing-operation materials instead of the standalone BOM lines. The BOM editor warns you when this applies.

The Buy List

The Buy List is the fastest way to see what you need to order right now. It is a live, computed-on-demand view — it never needs a separate "run MRP" step.

Navigate to Purchasing > Buy List.

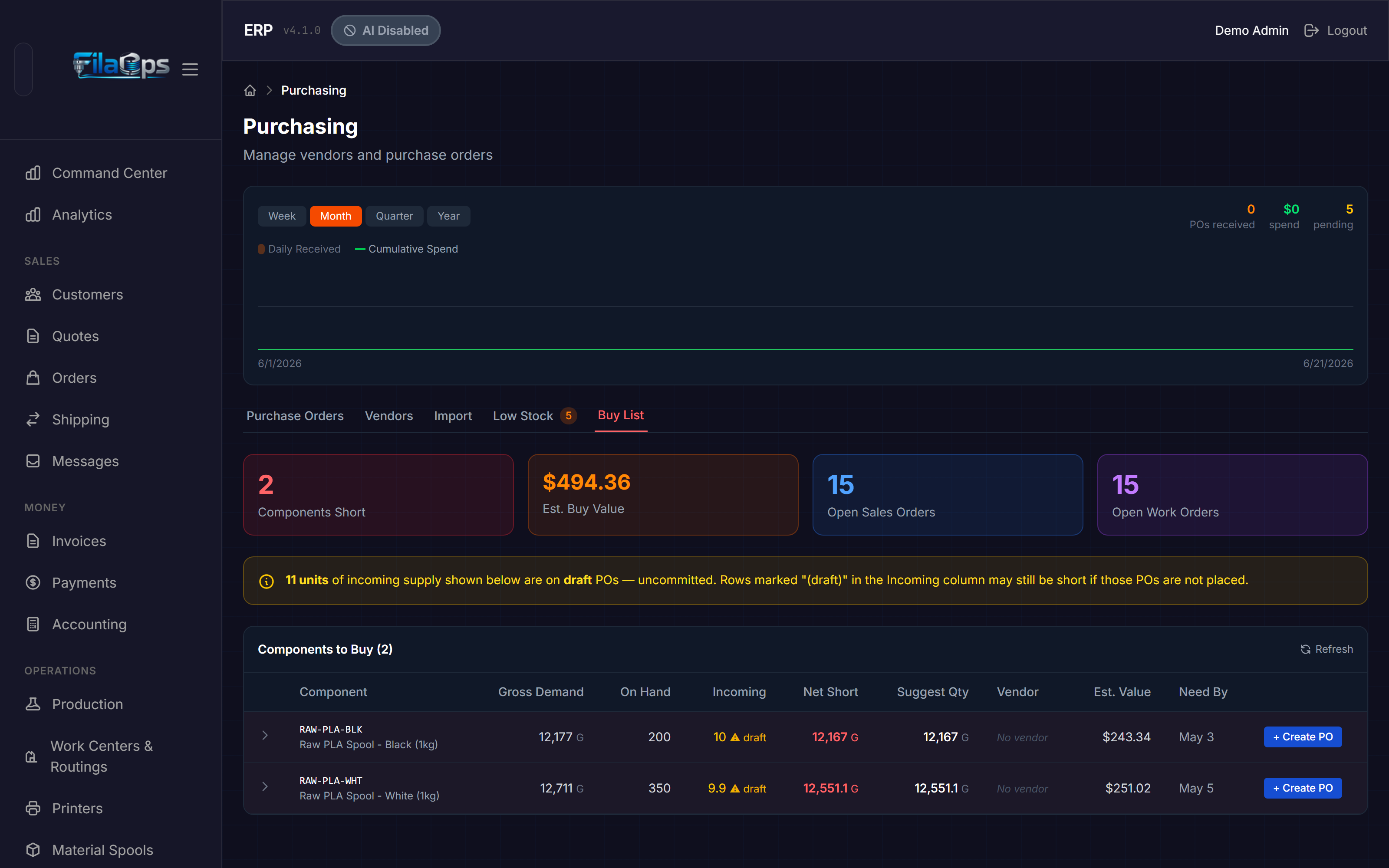

Buy List tab showing summary cards and the per-component shortage table

What the Buy List Shows

The summary cards at the top give you an at-a-glance status:

Card What It Shows
Components Short Number of distinct components with a net shortage
Est. Buy Value Estimated cost of all suggested purchases (quantity × last cost)
Open Sales Orders Count of sales orders included as demand
Open Work Orders Count of production orders included as demand

Draft PO warning

If any incoming supply is on draft purchase orders, the Buy List shows a yellow notice with the total uncommitted quantity. If those POs are not placed, those rows may still be short after you receive other orders.

Reading the Buy List Table

Each row represents one component with a shortage. Expand any row to see which open orders are driving the demand.

Column What It Shows
Component SKU and name of the material or sub-assembly
Gross Demand Total quantity needed across all open orders, after BOM explosion
On Hand Current inventory quantity (summed across all locations)
Incoming Quantity on open purchase orders not yet received
Net Short Gross Demand minus On Hand minus Incoming, plus Safety Stock
Suggest Qty Recommended order quantity — at least the net shortage, rounded up to the item's minimum order quantity
Vendor Preferred vendor set on the item
Est. Value Suggested Qty × last cost
Need By Earliest due date among the open orders consuming this component

Creating a Purchase Order from the Buy List

Step 1. Find the component row you want to order.

Step 2. Click Create PO on that row.

FilaOps navigates to Purchasing and opens the new purchase order form with the vendor and suggested quantity pre-filled.

Step 3. Confirm the vendor, adjust quantities if needed, and save the PO.

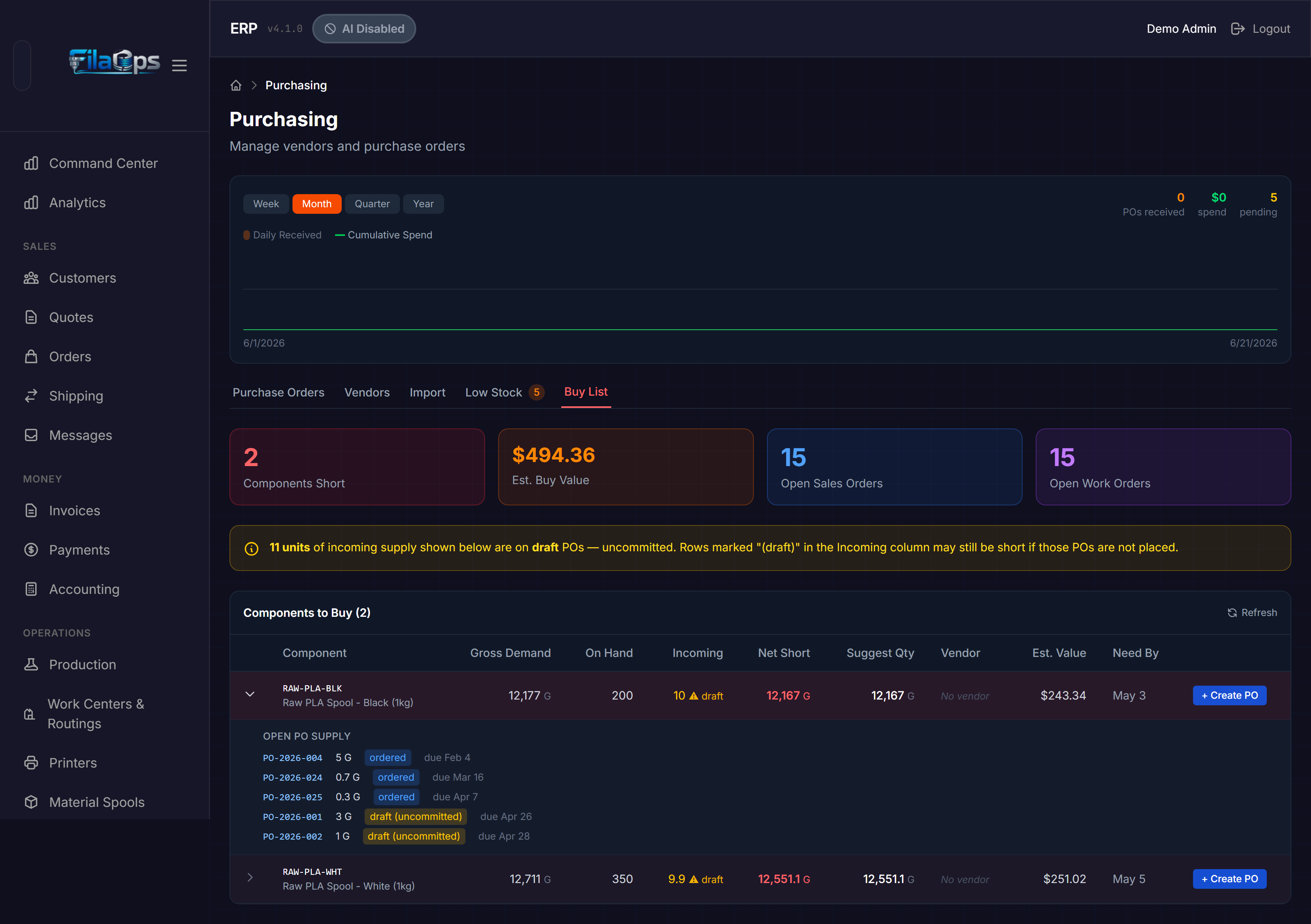

Buy List row expanded showing the open purchase-order supply breakdown (incoming quantities by PO, with draft POs flagged as uncommitted) and the Create PO button

Expand rows to see demand sources

Click the arrow on any row to expand it and see exactly which sales orders and work orders are driving the shortage. This helps you decide whether to order now or wait for more information.

Low Stock Tab

The Low Stock tab combines reorder-point alerts with MRP-driven shortages into one prioritized list.

Navigate to Purchasing > Low Stock.

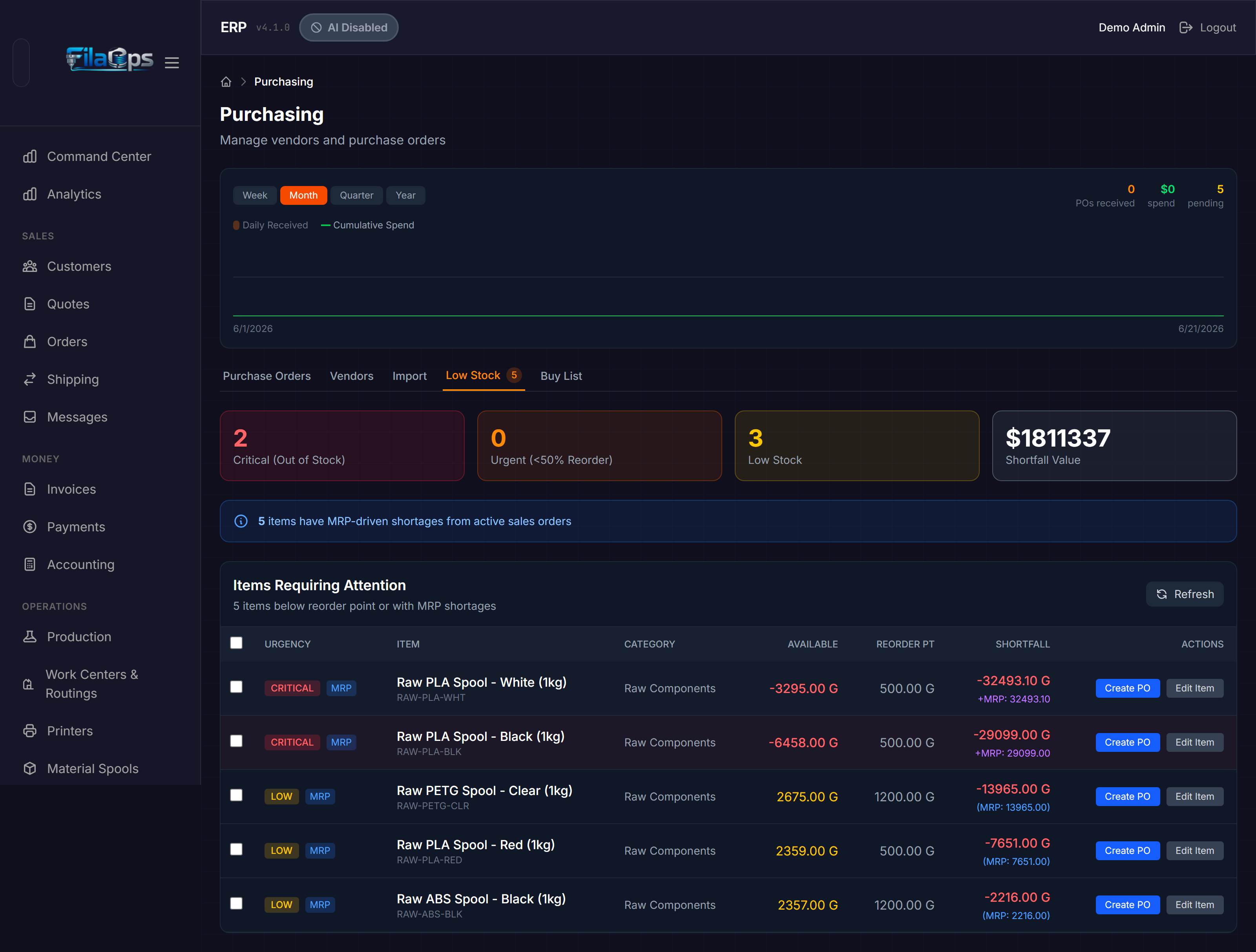

Low Stock tab showing critical, urgent, and MRP-flagged items with urgency badges and Create PO buttons

Urgency Levels

Each item is assigned an urgency badge:

Badge Condition
CRITICAL (red) Available quantity is zero or below
URGENT (orange) Available quantity is below 50% of the reorder point
LOW (yellow) Available quantity is below the reorder point
MRP (blue) MRP calculation shows a future shortage from open orders

An item can show both a standard urgency badge and the MRP badge at the same time. The Shortfall column then shows both figures.

Shortage Source Values

The Shortfall column shows how the shortage was identified:

Display Meaning
-qty unit Shortage from reorder point breach
(MRP: qty) Shortage is MRP-only, driven by open order demand
+MRP: qty Shortage from both the reorder point and MRP

Creating Purchase Orders from Low Stock

Single item:

  1. Click Create PO on any row to open the new PO form pre-filled for that item.

Multiple items (bulk by vendor):

  1. Check the boxes next to the items you want to order.
  2. Click Create PO (n) in the toolbar.
  3. Choose a vendor group from the dropdown — items are grouped by their preferred vendor.

Items without a preferred vendor cannot be bulk-ordered

The bulk workflow requires a preferred vendor set on each item. Items with no preferred vendor are listed separately and must be ordered individually. Set preferred vendors in Items > edit item > Preferred Vendor.

Running Full MRP

The Buy List computes automatically. When you need a formal review-and-approve workflow — including planned orders — you run the MRP engine explicitly.

API-only in the current release

The full MRP run (with planned order generation) is invoked via the staff API (POST /api/v1/mrp/run). A UI for this workflow is planned for a future release. The Buy List and Low Stock views handle the majority of daily purchasing decisions without a manual MRP run.

MRP Run Parameters

Parameter Default What It Controls
planning_horizon_days 30 How far into the future to look for demand (1–365 days)
include_draft_orders true Whether to include production orders in draft status alongside released and in_progress orders
regenerate_planned true When true, all unfirmed planned orders are deleted and recreated fresh. Set to false to keep planned orders you have already reviewed

Regenerate clears unfirmed planned orders

With regenerate_planned: true (the default), every planned order that has not been firmed will be deleted and recreated. Firm any planned orders you want to preserve before re-running MRP.

What a Run Produces

After a successful run the MRP engine records:

  • Orders processed (sales orders + production orders)
  • Components analyzed
  • Shortages found
  • Planned orders created

Planned Orders

When you run the full MRP engine, it generates planned orders — suggestions you review and approve before they become real purchase orders or work orders.

Types of Planned Orders

Type When Created What It Becomes
Planned Purchase Order (purchase) When a bought material (no BOM) has a net shortage A real purchase order in Purchasing
Planned Production Order (production) When a manufactured sub-assembly (has its own BOM) has a net shortage A real production order in Production

FilaOps determines the type automatically: items with a BOM become production orders; items without a BOM become purchase orders.

Planned Order Lifecycle

Planned  →  Firmed  →  Released
   │           │
   └─────── Cancelled ◄──┘
Status Meaning
Planned MRP's suggestion. Automatically deleted or replaced when you re-run MRP with regenerate_planned: true.
Firmed You reviewed and locked this order. MRP will not modify or delete firmed orders on subsequent runs.
Released Converted into an actual purchase order or production order. The planned order is closed.
Cancelled No longer needed. Released orders cannot be cancelled — cancel the underlying PO or work order instead.

Working with Planned Orders

Firming a Planned Order

When you have reviewed a planned order and agree with the suggestion:

  1. Select the planned order.
  2. POST to /api/v1/mrp/planned-orders/{id}/firm (optionally include a notes string).

Firming locks the order so the next MRP run will not change or delete it. Firm orders when you are confident in the quantity but are not yet ready to release.

Releasing a Planned Order

When you are ready to convert a planned order into a real order:

  1. POST to /api/v1/mrp/planned-orders/{id}/release.
  2. For purchase planned orders, include vendor_id in the request body (required).
  3. For production planned orders, no vendor is needed — FilaOps creates the work order automatically using the product's active BOM.

FilaOps creates the actual purchase order (visible in Purchasing) or production order (visible in Production) and marks the planned order as released.

Cancelling a Planned Order

If a planned order is no longer needed:

  1. DELETE /api/v1/mrp/planned-orders/{id}.

Only planned or firmed orders can be cancelled. Released orders cannot be cancelled.

MRP Across the App

MRP results appear in several places beyond the Purchasing page.

Order Detail — Material Requirements

When viewing a sales order, the Material Requirements section shows a BOM explosion for that specific order and nets the quantities against available inventory. This lets you see at a glance whether materials are covered before you schedule production.

Sales order detail page showing the Material Requirements section with BOM explosion and per-component availability

Dashboard

The main dashboard surfaces two MRP-related cards:

  • Low Stock Items — items below their reorder point or with an MRP shortage. Clicking takes you directly to Purchasing > Low Stock.
  • Orders Needing Materials — count of open sales orders in scope for MRP planning.

Stocking Policy per Item

Each item in your catalog has a Stocking Policy that controls how it interacts with purchasing alerts:

Policy Behaviour
Stocked (reorder point) Item triggers a Low Stock alert when quantity drops below its reorder point, regardless of open orders
On-Demand (MRP-driven) Item is only flagged when MRP shows active demand from an open order; no reorder-point alert

Set the stocking policy in Items > edit item > Stocking Policy.

Tips and Best Practices

  • Use the Buy List for daily purchasing decisions — It is always current without a manual run. Reserve the full MRP engine with planned orders for formal review-and-approve workflows.
  • Set accurate lead times — MRP timing is only as good as your lead time data. Update lead times when a vendor consistently delivers faster or slower than expected.
  • Keep safety stock configuredsafety_stock on an item raises the net shortage floor. MRP suggests enough quantity to cover demand plus your safety stock buffer.
  • Set preferred vendors on all purchased items — The Buy List and bulk PO creation both group by preferred vendor. Items without a preferred vendor must be ordered individually.
  • Firm planned orders before re-running MRP — If you have reviewed planned orders and want to keep them, firm them before running MRP again with regenerate_planned: true.
  • Check the BOM when quantities look wrong — If MRP is suggesting unexpected quantities, review the product's BOM. The most common cause is a wrong quantity-per-assembly on a BOM line. Check whether routing-operation materials are overriding BOM lines (the BOM editor will warn you if so).
  • Use "Include Draft Orders" for early planning — Set include_draft_orders: true (the default) so that draft production orders — not yet formally released — are included in demand. This gives you advance warning before orders are confirmed.

What's Next?

Quick Reference

Task Where to Find It
View live buy list Purchasing > Buy List tab
View low stock and MRP shortage alerts Purchasing > Low Stock tab
Create a PO from a shortage Purchasing > Buy List > Create PO on any row
Bulk-create POs by vendor from Low Stock Purchasing > Low Stock > check items > Create PO (n)
View material requirements for an order Open the order > Material Requirements section
Run full MRP (generates planned orders) POST /api/v1/mrp/run
List recent MRP runs GET /api/v1/mrp/runs
List planned orders GET /api/v1/mrp/planned-orders
Firm a planned order POST /api/v1/mrp/planned-orders/{id}/firm
Release a planned order to a PO or WO POST /api/v1/mrp/planned-orders/{id}/release
Cancel a planned order DELETE /api/v1/mrp/planned-orders/{id}
View supply/demand timeline for an item GET /api/v1/mrp/supply-demand/{product_id}
Explode a BOM to see all components GET /api/v1/mrp/explode-bom/{product_id}
Set stocking policy on an item Items > edit item > Stocking Policy
